This is a culvert replacement project under a road that provides exclusive access to several homes in the Quail Hollow Subdivision. Therefore, at least one lane of traffic remains open at all time. *Budget changes reflect action by the Board of Commissioners.
Latest Update:
Construction activities are complete, this project was completed in March 2020.
Timeline:
- 1/15/2019 ROW acquired
- 5/06/2019 NTP issued to contractor

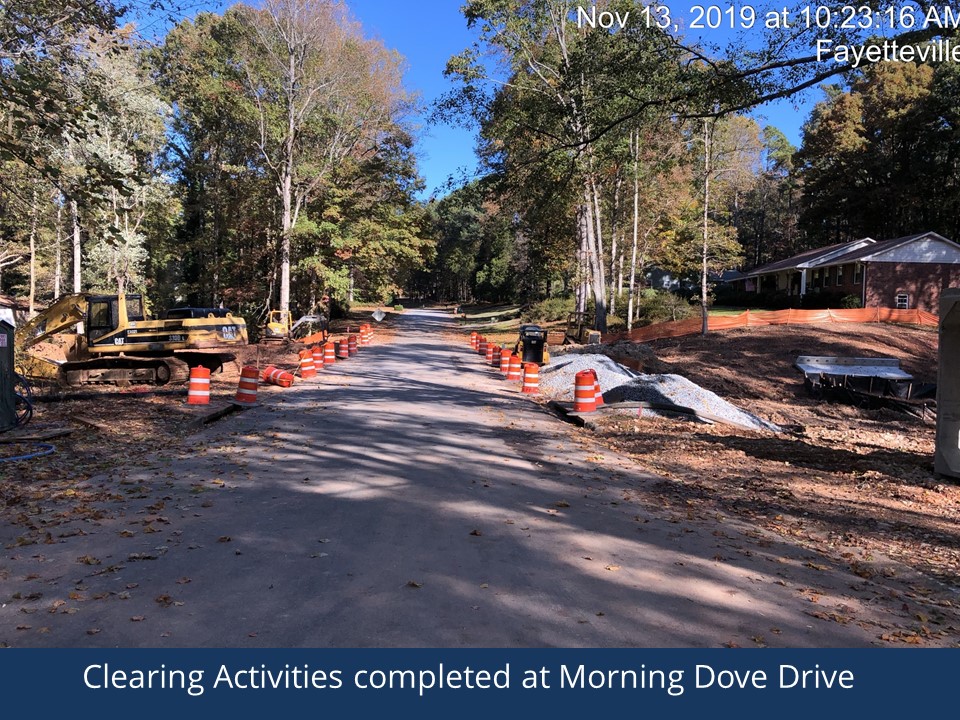

- 10/14/2019 Construction began
- 10/31/2019 Pre-cast culvert delivery
- 11/01/2019 Utility relocations complete

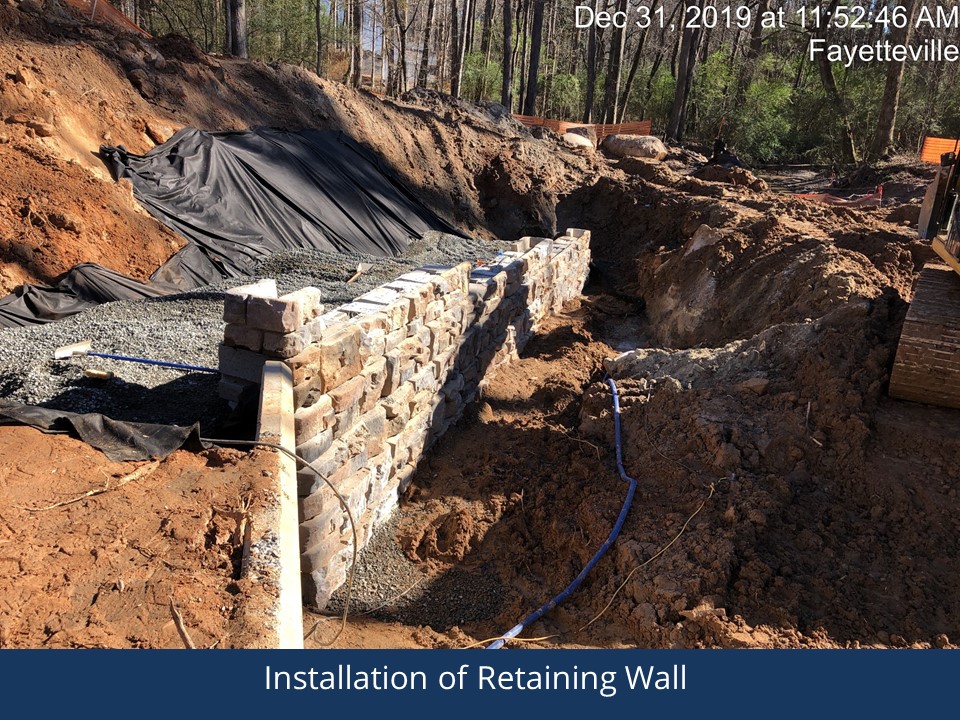

- 12/16/2019 Pre-cast retaining wall delivery

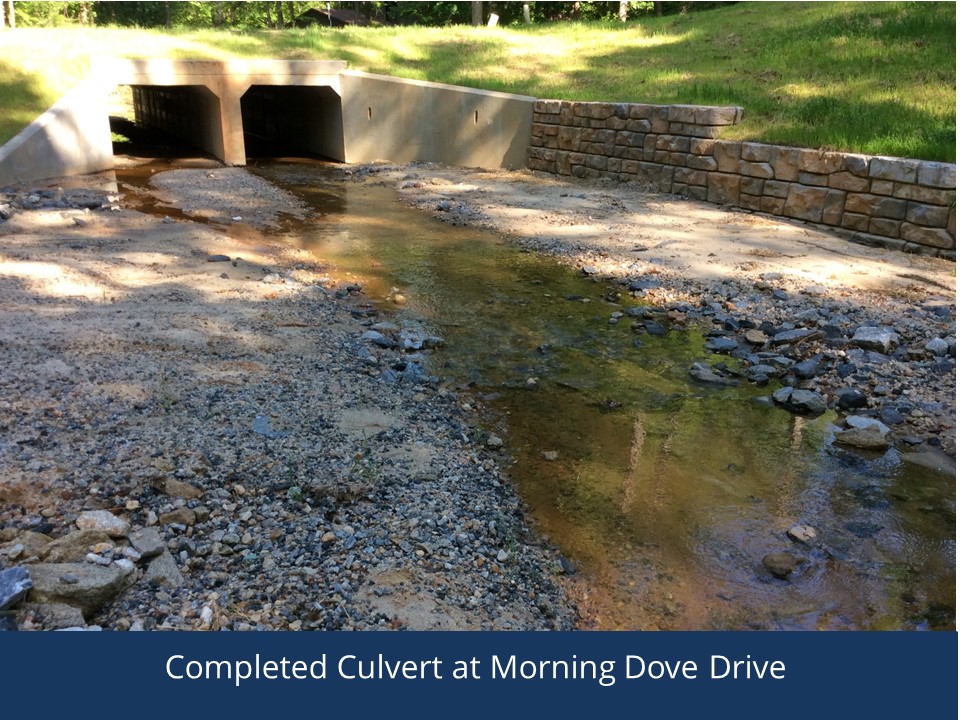

- 1/27/2020 Culvert construction complete
- 2/05/2020 Curb & Gutter construction complete
- 2/26/2020 Milling of roadway complete

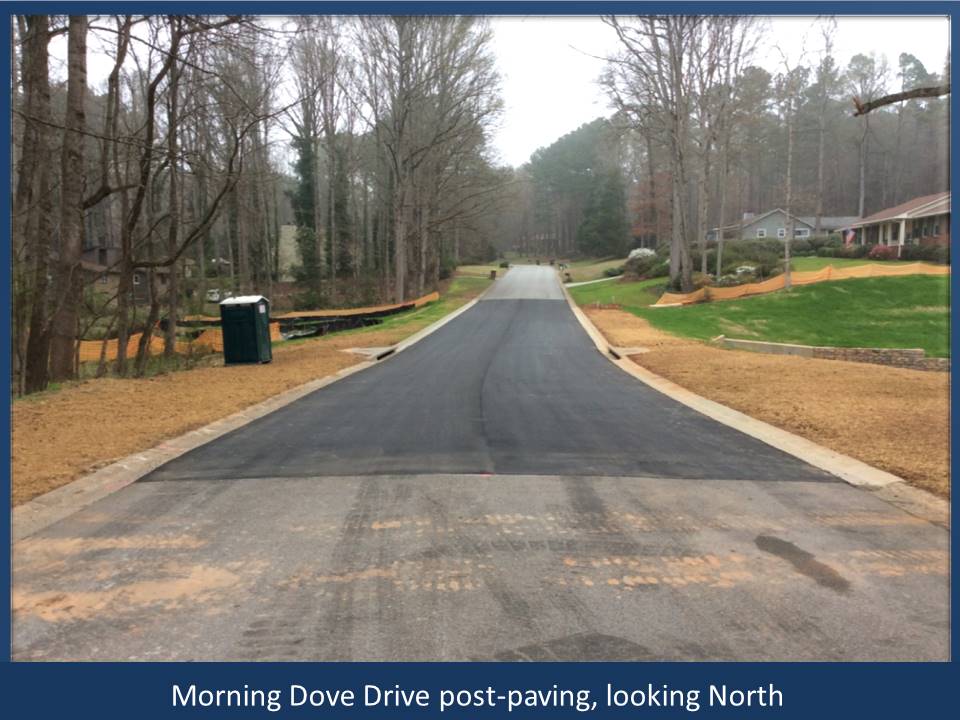

- 3/09/2020 Paving complete
- 3/23/2020 Substantial completion
