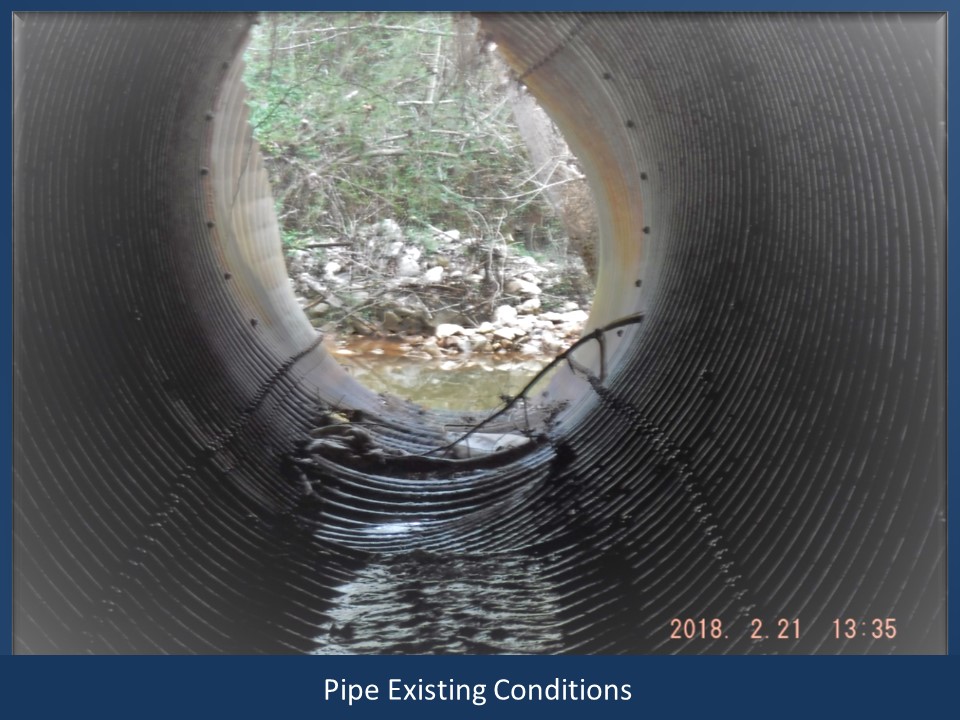

This is a culvert replacement project on Kenwood Road near Creekwood Court. A 96-inch corrugated metal pipe is severely rusted on both ends and is currently failing. In 2018 the north edge section of pavement cracked resulting in the shoulder sloughing. A temporary repair to the pipe was completed while design of a permanent replacement structure was being completed. *Indicates changes approved by Board of Commissioners
Latest Update:
Kenwood Road is now open to all traffic. The construction of a double 8-ft X 8-ft concrete box culvert is complete. Expect periodic lane closures with minor delays while final tasks are being completed over the next few weeks.
Timeline:
- 2/28/2018 Temporary Repair
- 9/23/2019 All necessary ROW acquired
- 3/13/2020 Final plans approved
- 3/19/2020 Invitation to Bid
- 4/08/2020 Bid Opening
- 5/06/2020 Notice to Proceed to Contractor
- 5/15/2020 Pre-Construction Meeting

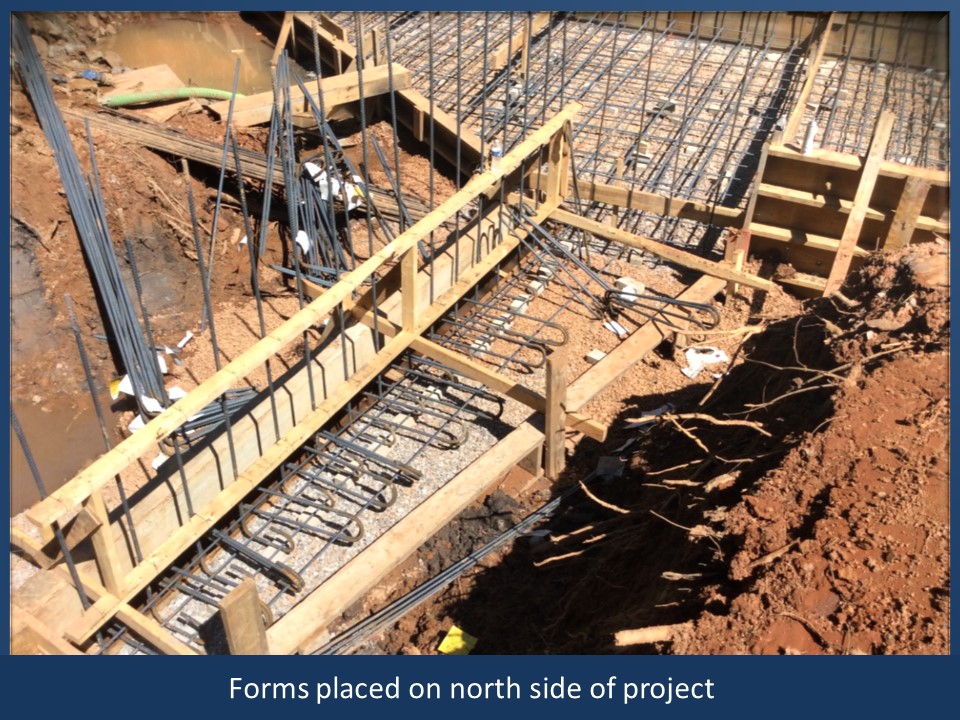

- 6/10/2020 Demolition and culvert forms places
- 6/24/2020 Forming and pouring continue
- 7/8/2020 Pouring complete, pending backfill
- 8/13/2020 Road open
- 9/24/2020 Ribbon Cutting Ceremony

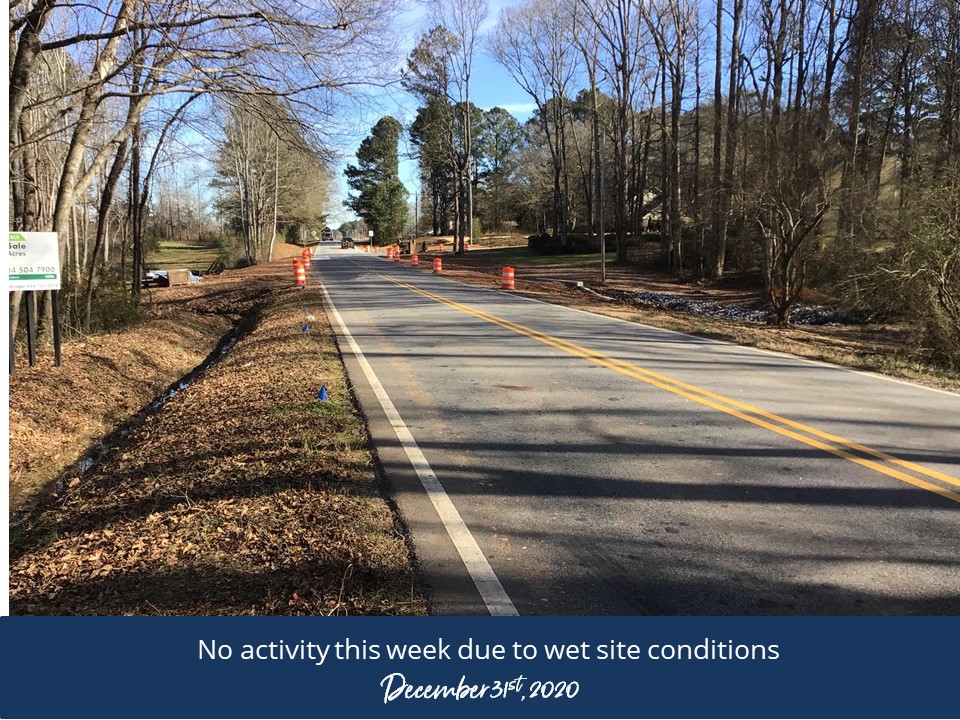

- 12/09/2020 - Project pending delivery of the remainder of guardrail materials. Final grading to take place with Creekwood Court and Mercedes Trail. Milling and paving to follow.

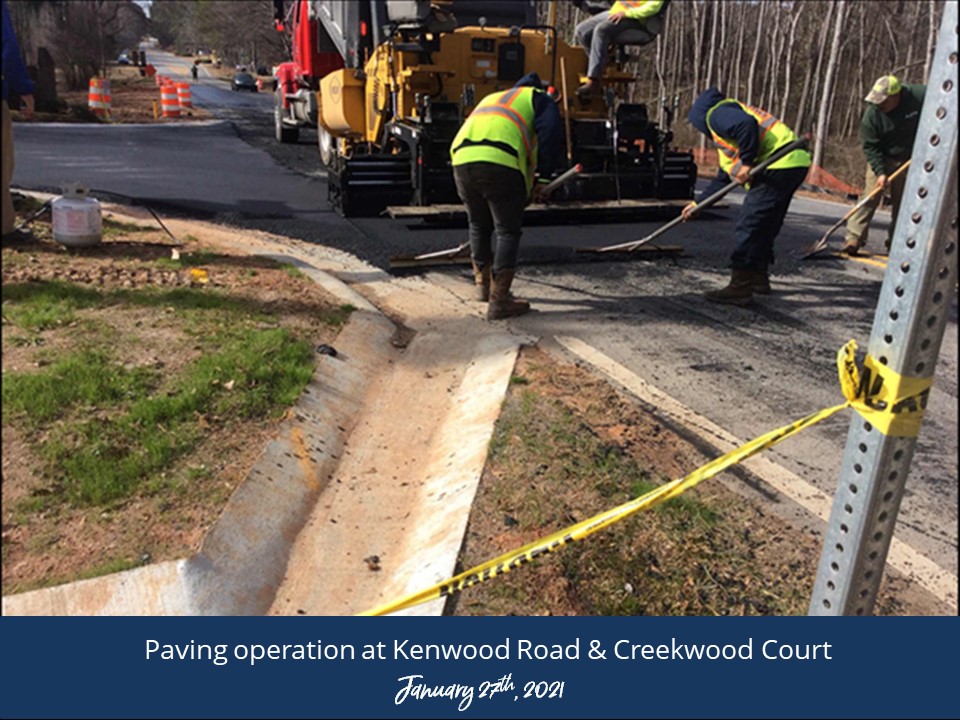

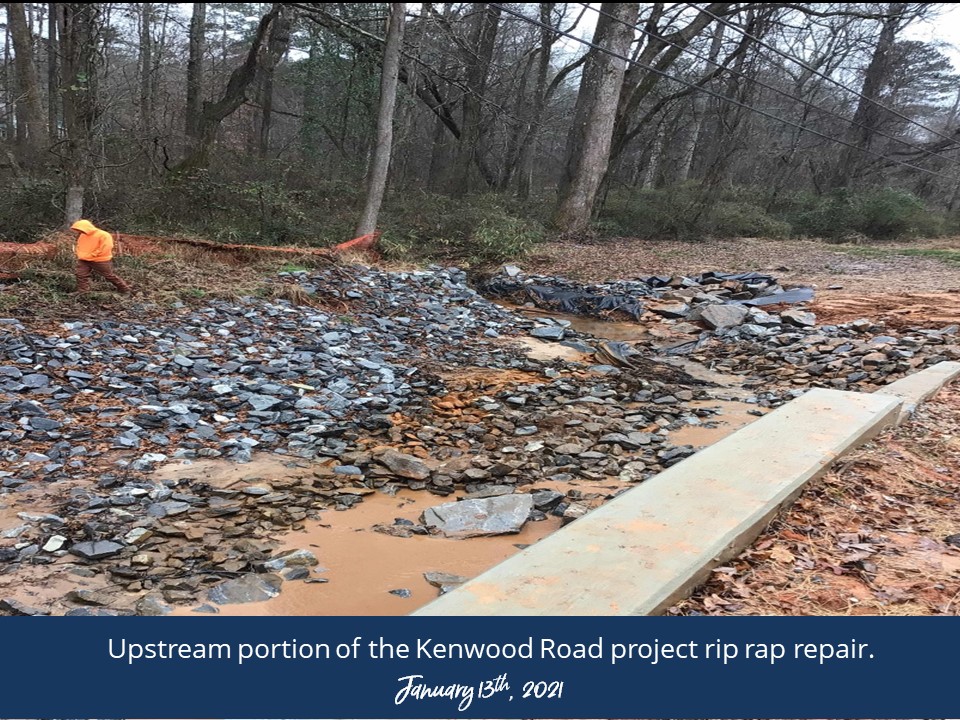

- 1/27/2021 - Asphalt debris removed from curbing and catch basins

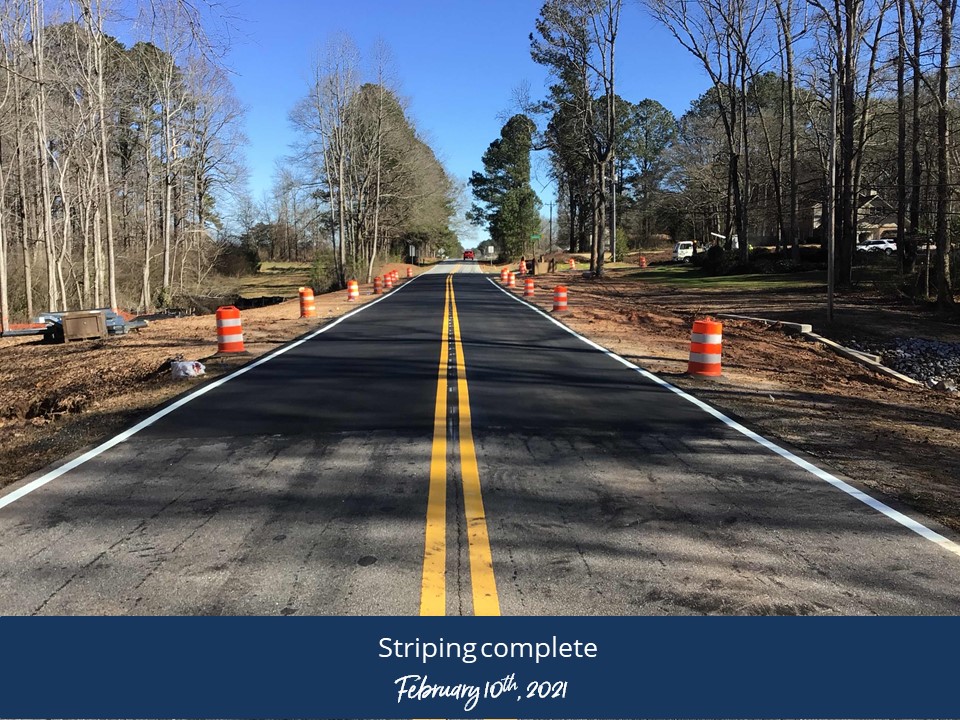

- 2/10/2021 - Crew onsite this week for guardrail installation. Striping crew completed with project.

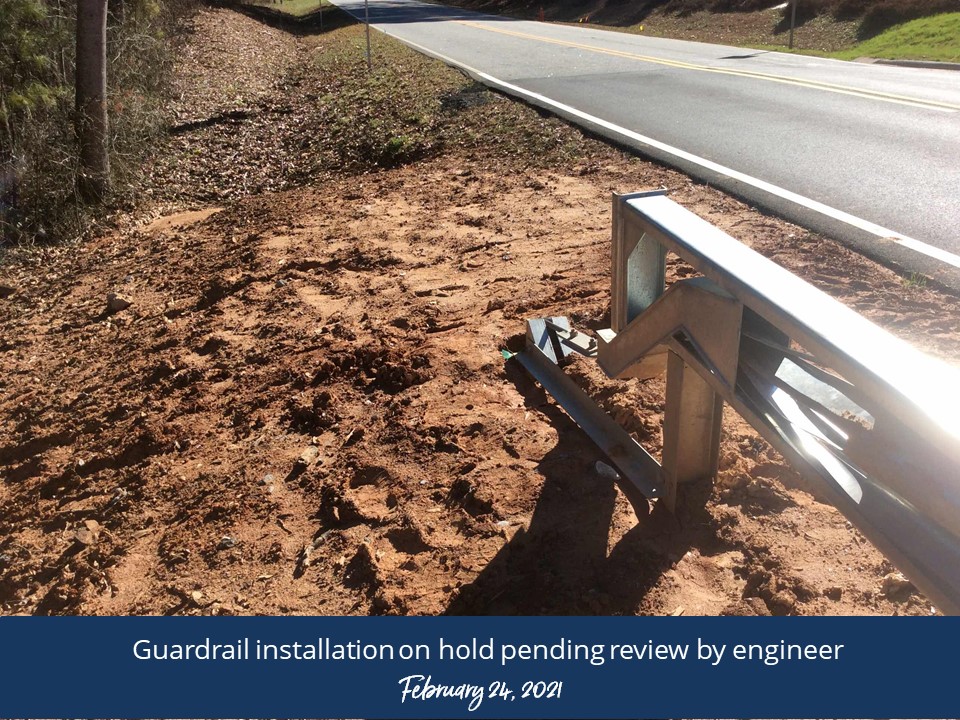

- 2/24/2021 - RFI submitted by contractor for guardrail installation.

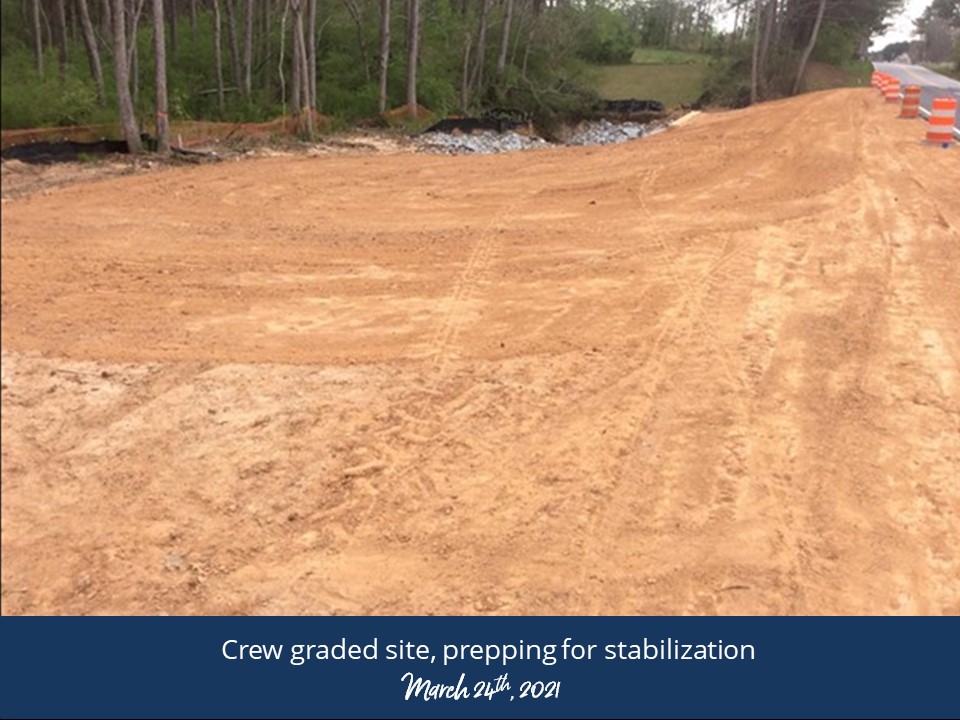

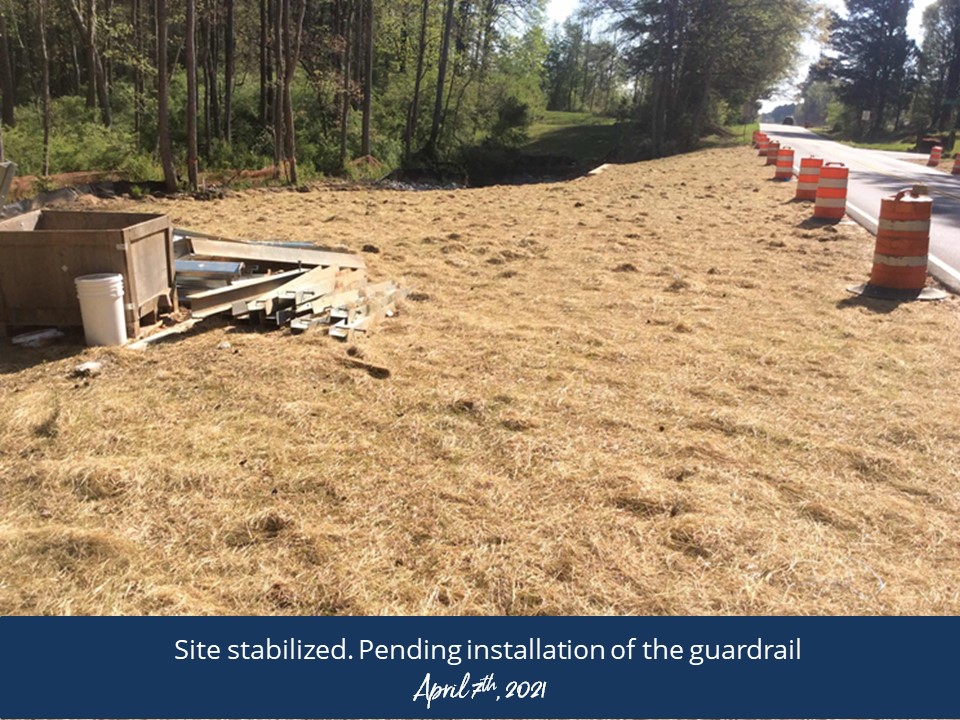

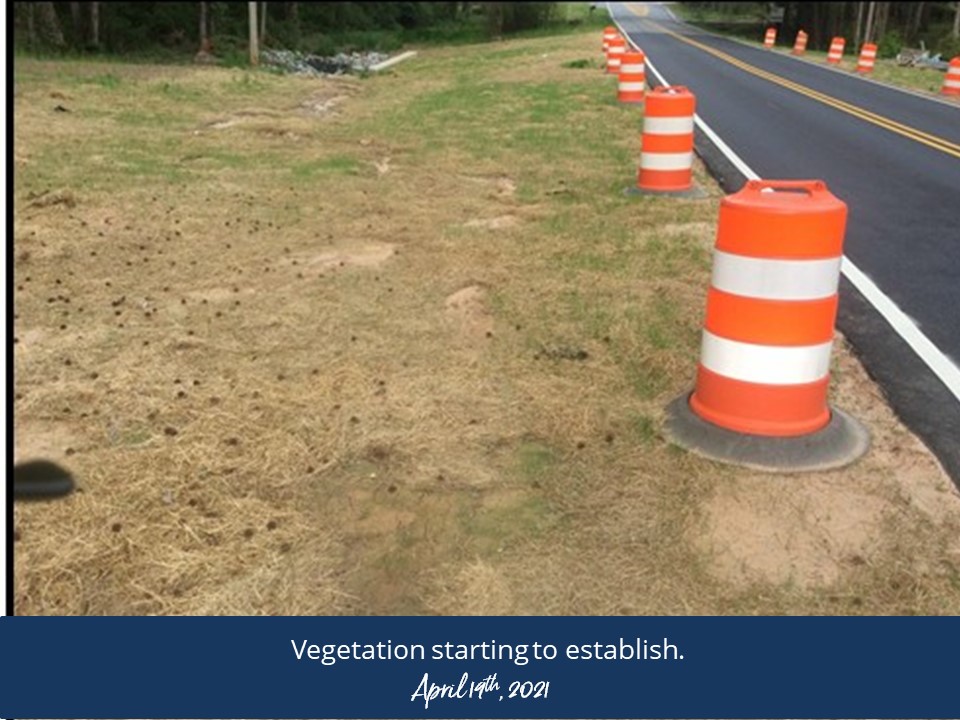

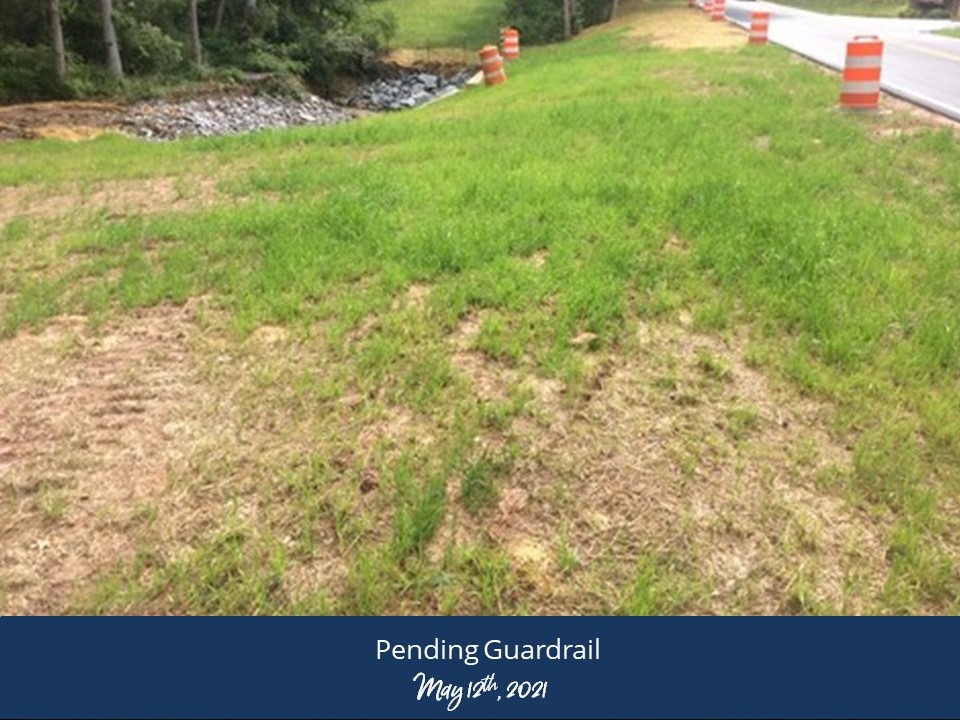

- 4/7/2021 - Site stabilized. Pending installation of the guardrail.

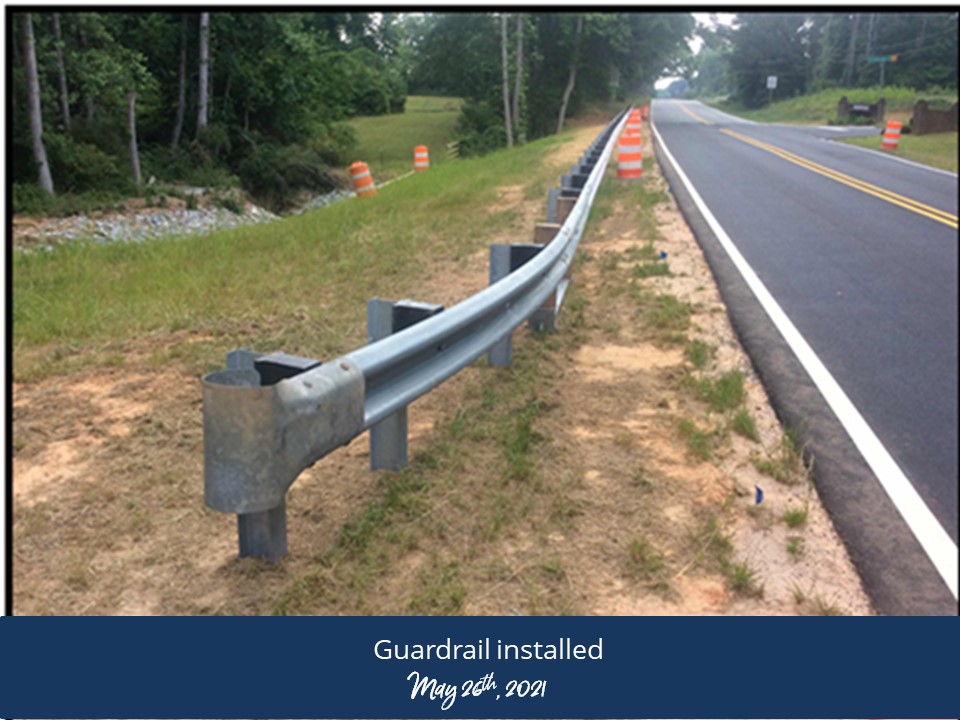

- 5/27/2021 - Guardrail installed

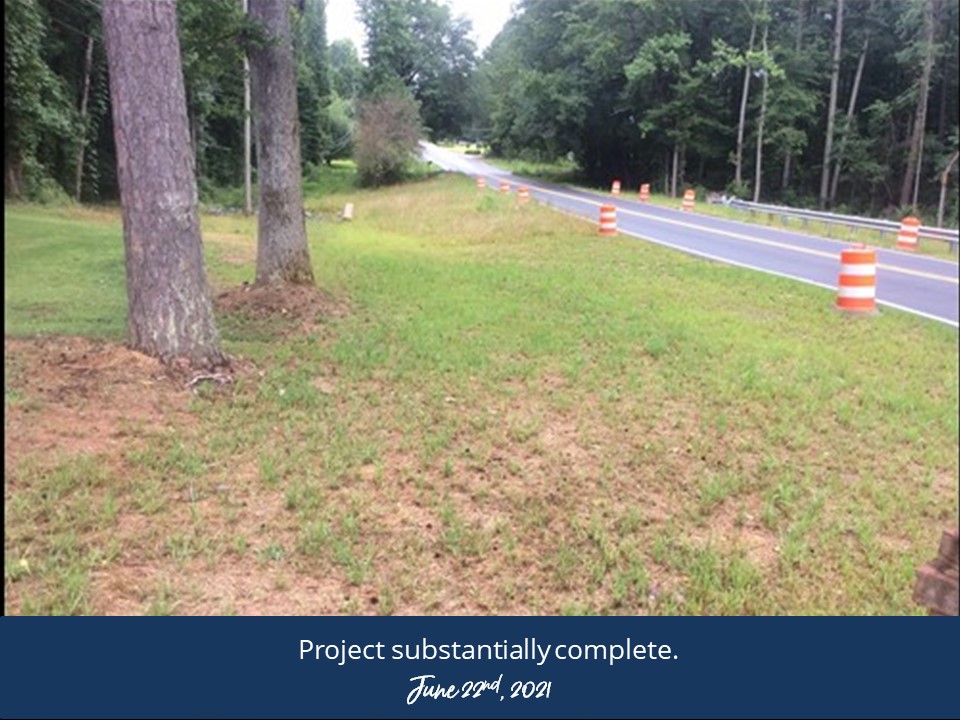

- 6/22/2021 - Project substantially complete. Pending punch list items.
- 8/11/2021 - Contractor repaired pipe from Creekwood Court and stabilized site. Mercedes Trail punch list is complete as well.

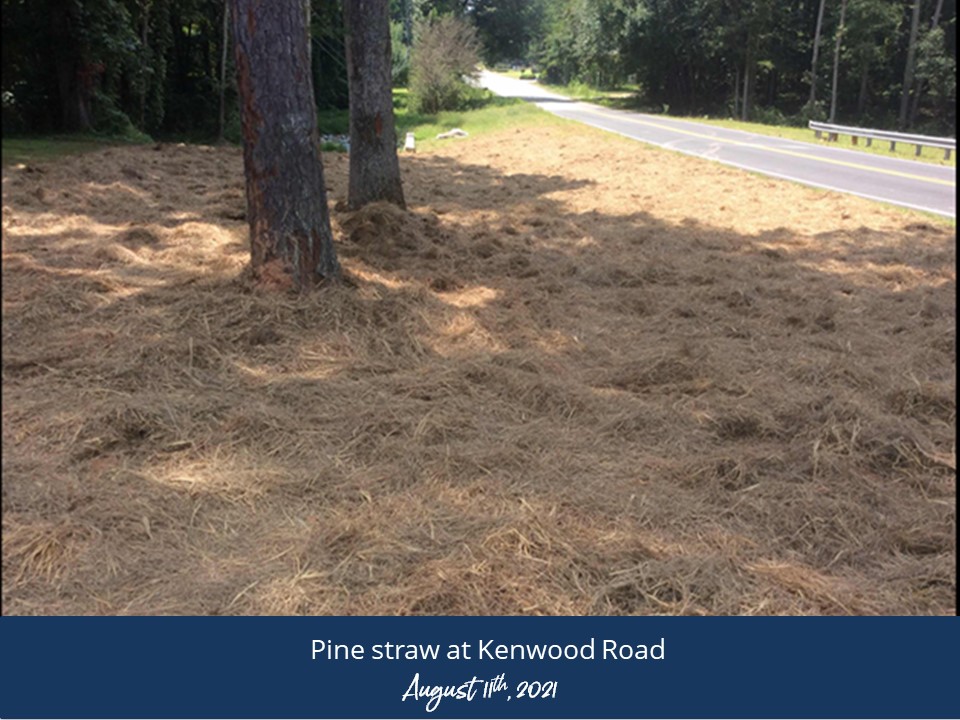

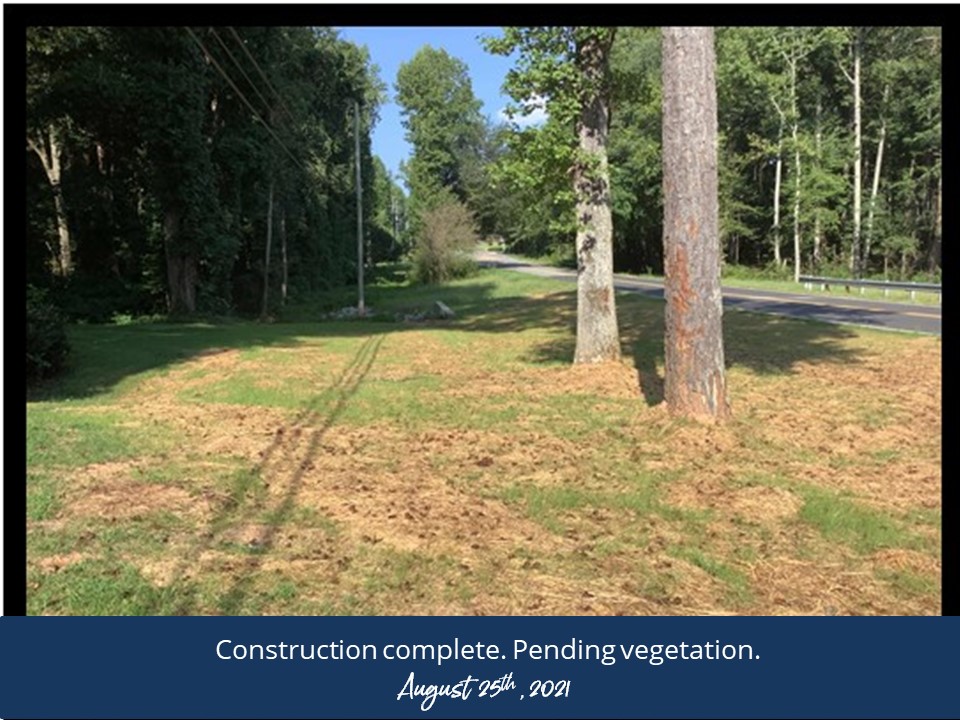

- 8/25/2021 - Complete. Pending vegetation.
