Redwine Road Multi-Use Path Status: Construction Last Updated: May 19, 2023 Expected Completion:

Budgeted & Pending
In Design
Under Construction
Completed

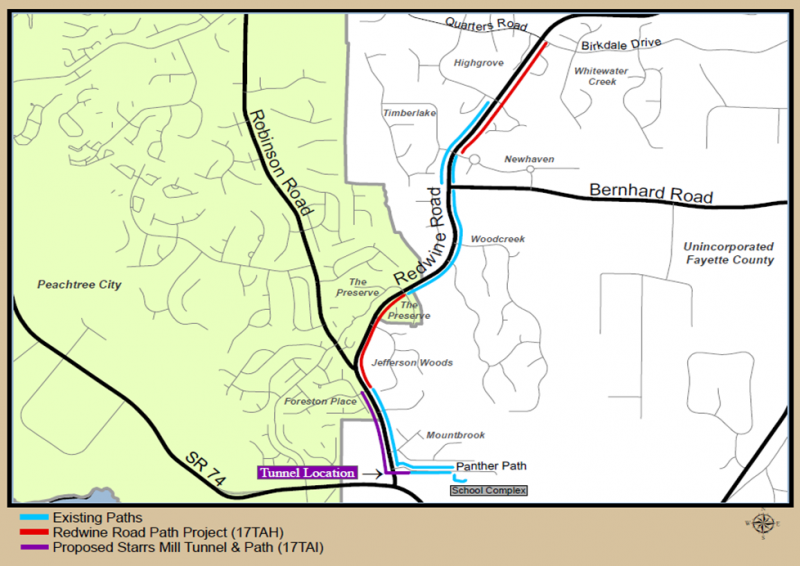

  • redwinemultiusepath_existing_condition.png
This is an existing, federal-aid, design-build project installing 1.5 miles of new multi-use path along Redwine Road. When complete, there will be a continuous path along Redwine Road from Birkdale Drive to Panther Path. The project will also include an at-grade crossing of Redwine Road near the Birkdale Drive and Quarters Road intersection. *Budget changes reflect action by the Board of Commissioners.
Latest Update:

This project is currently in the utility relocation phase.



Timeline:

04/09/2021 - Invitation to Bid (Rebid)

05/27/2021 - Board Approval

07/12/2021 - GDOT Construction Agreement

09/30/2021 - GDOT Notice to Proceed to Award

10/27/2021 - Notice to Proceed to Helix Group

05/17/2023 - Utility Relocation

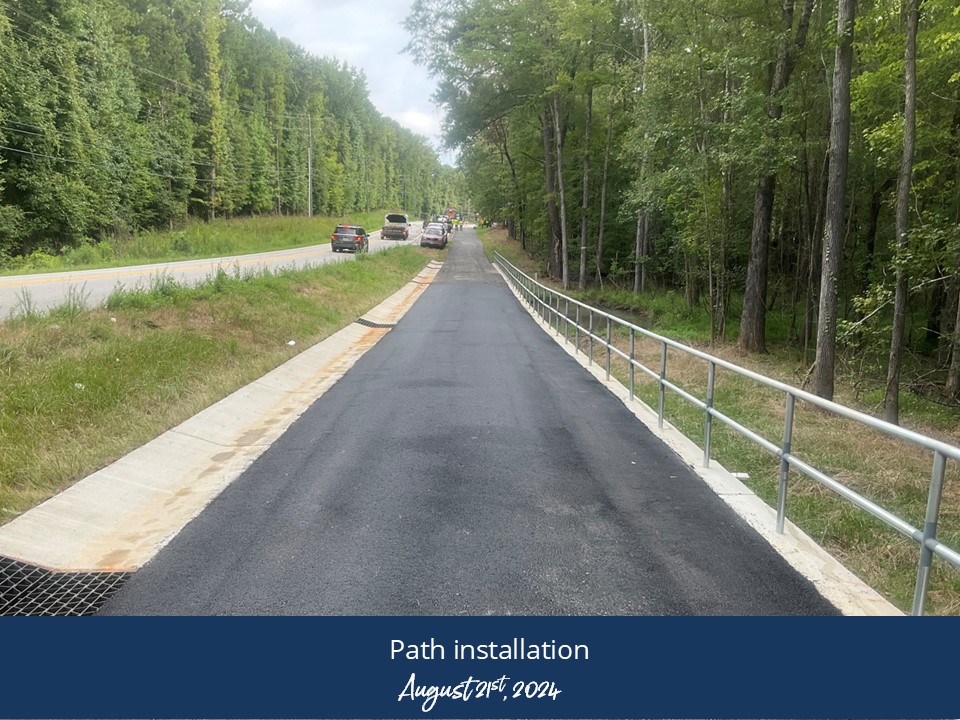

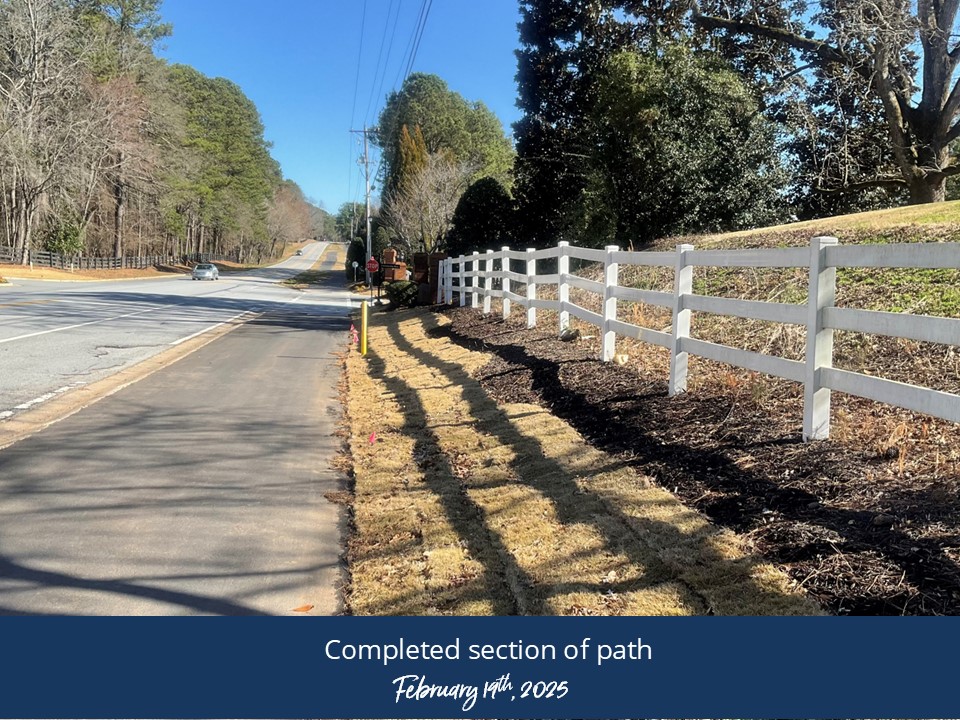

08/24/2023 - Construction Phase





  • Approved Budget: $556,680
  • Revised Budget: $2,308,948*
  • Category: Pedestrian, Bicycle, & Multi-Use Path Projects
  • Expended to Date: $1,332,335
  • Designer: Heath & Lineback Engineers, Inc.
  • Contractor: Helix Group, Inc.
