This project was completed July 2022.

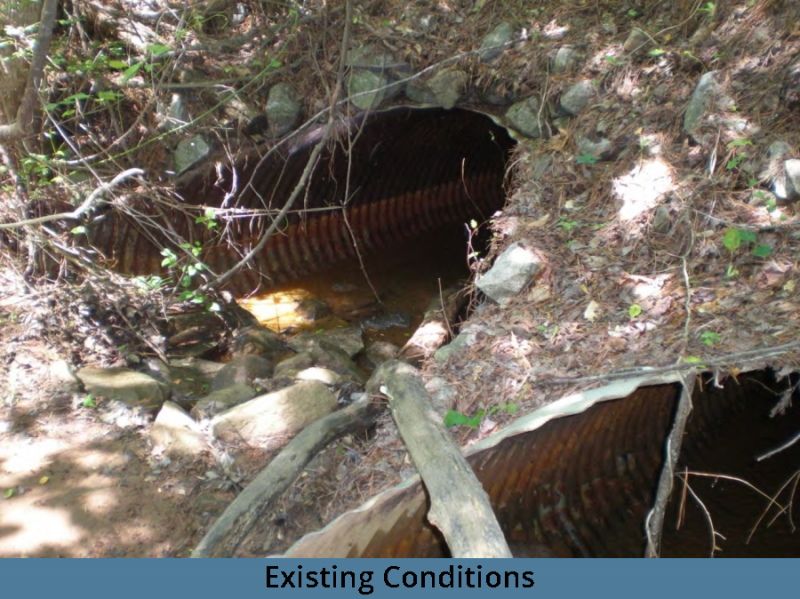

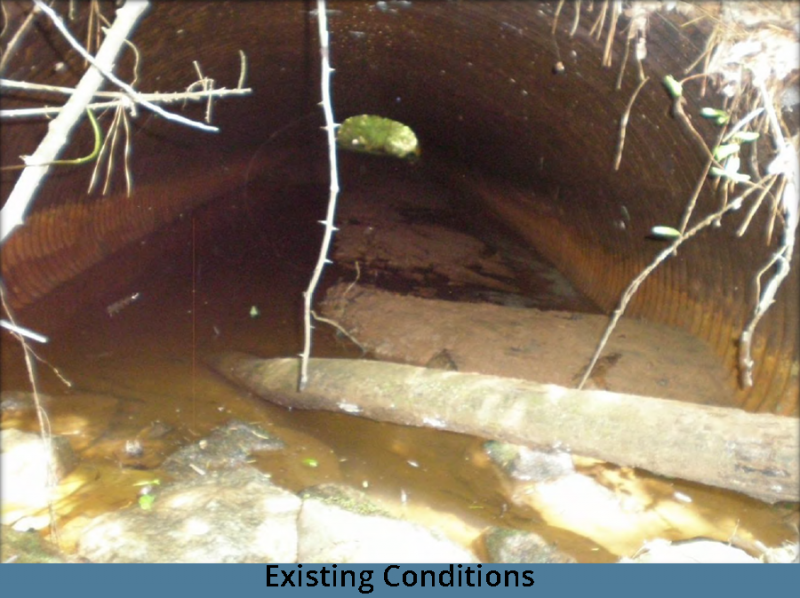

The project consisted of a culvert replacement project on Mercedes Trail. The deteriorating 48-inch corrugated metal pipe is being replaced with a Double 9-ft by 6-ft Reinforced Concrete Box Culvert along with minor improvements to an existing and adjacent 18-inch corrugated metal pipe.
Timeline:
- 10/5/2020 Temporary road work for traffic shift
- 10/6/2020 Excavation of upstream culvert area
- 10/21/2020 Forms and steel placed to prepare for concrete.
- 10/30/2020 Crew completed concrete pour on upstream portion of culvert.
- 11/6/2020 Crew removed forms. They are backfilling dirt and compacting around culvert.
- 11/12/2020 Backfilling and compaction of the sub-base is complete.
- 11/20/2020 Plumbing onsite to install water main over new culvert

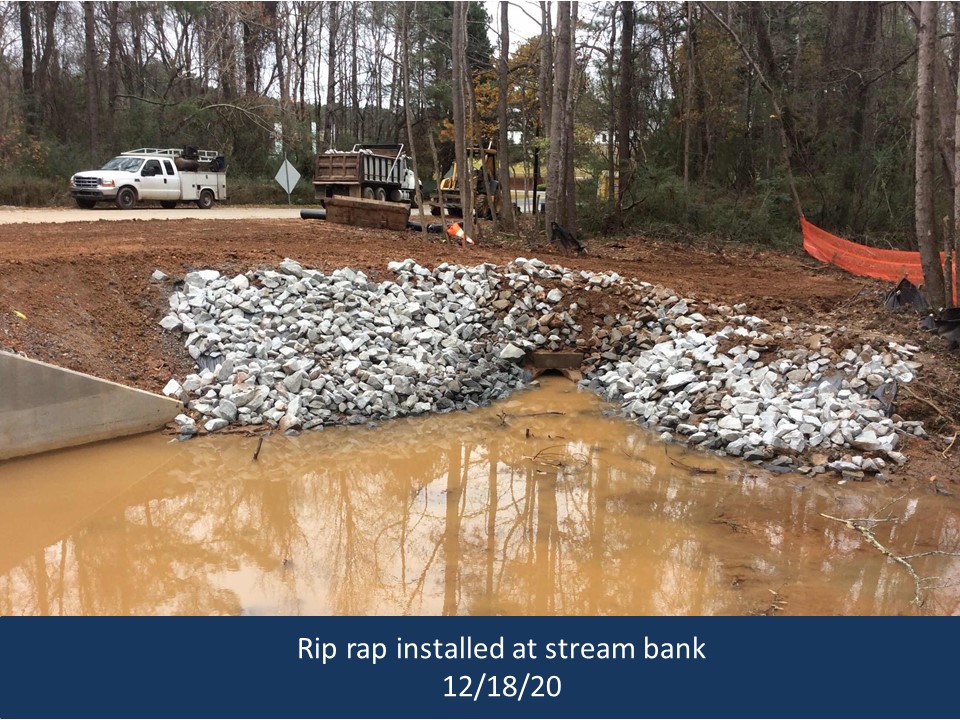

- 12/18/2020 Rip rap installed

- 12/31/20 No site activity due to wet site conditions

- 1/13/2021 - Crew installed curbing and backfilled. Final grading, stabilization and paving pending.

- 1/27/2021 - McLeroy Grading paved project limits.

- 2/10/2021 - Pine Valley crew grading areas not saturated by rain events.

- 2/24/2021 - Site conditions have been saturated. No activity.

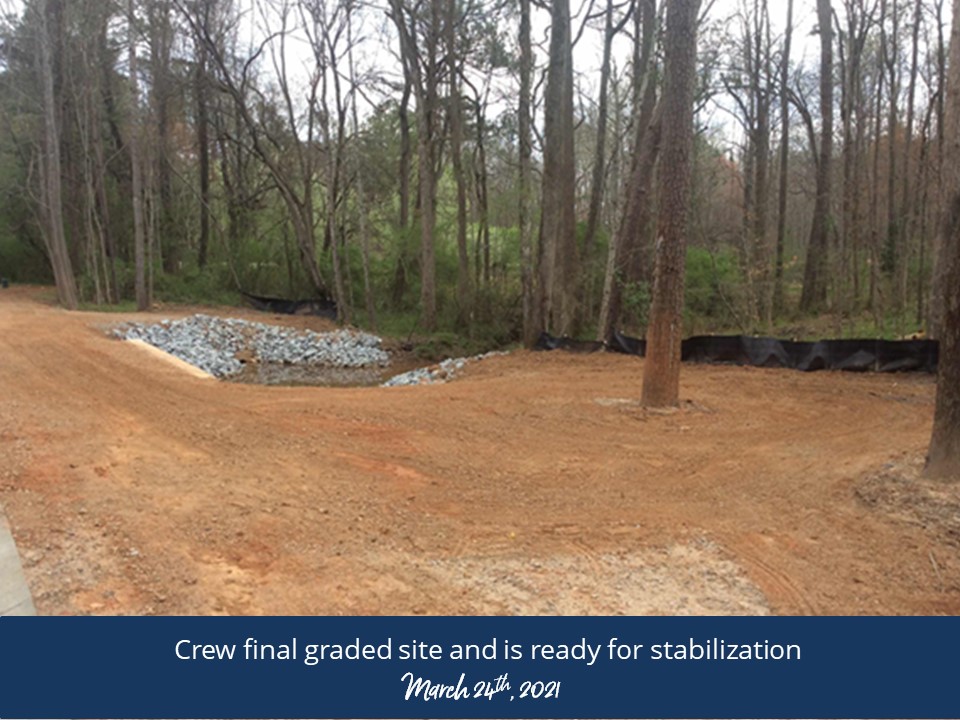

- 3/24/2021 - Crew final graded site and is ready for stabilization.

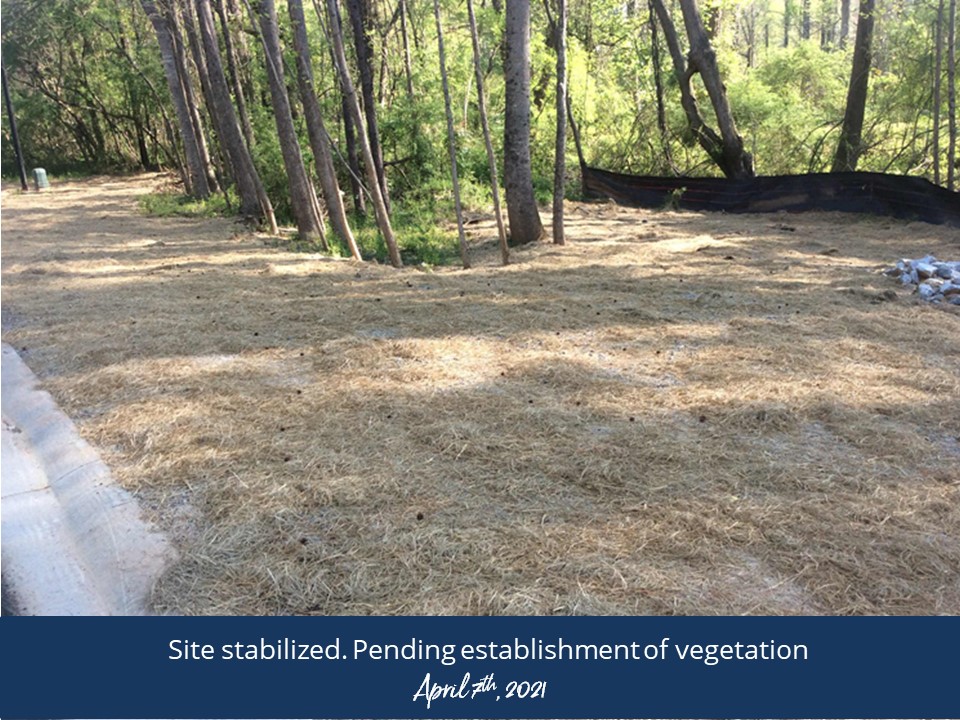

- 4/7/2021 - Site stabilized. Pending establishment of vegetation.

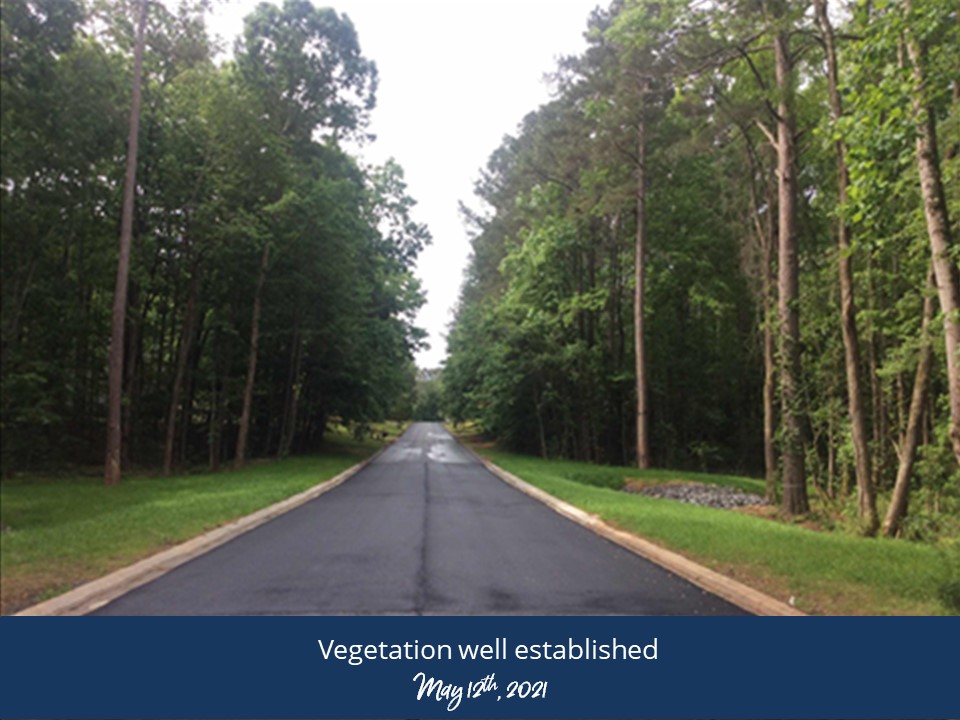

- 5/12/2021 - Vegetation well established.
Approved Budget: $224,070.00
Revised Budget: $471,508.00*
Category: Category II, Tier I
Expended to Date: $502,133.00
Designer: Tetra Tech
Contractor: Pine Valley Concrete
