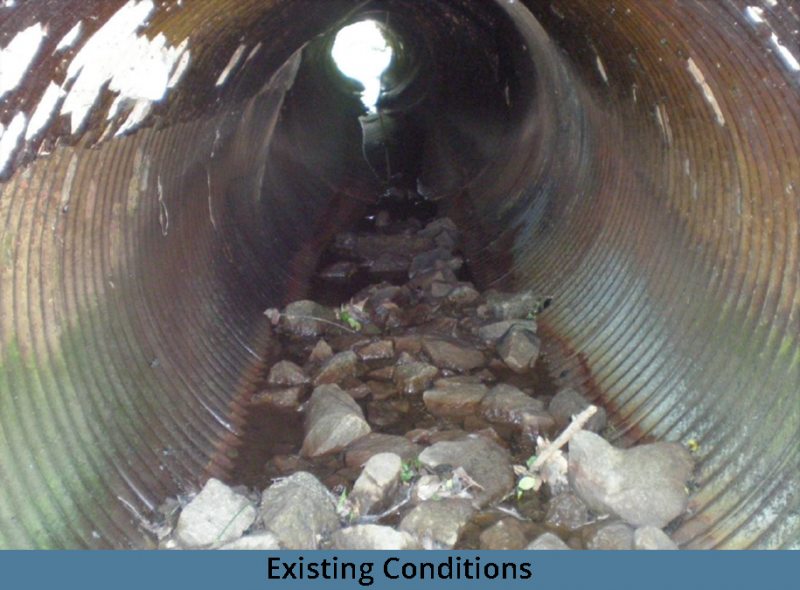

A 54” currugated metal pipe (CMP) under Patricia Lane has been evaluated for replacement. The current pipe exhibits signs of joint failure, deterioration, scour, and debris buildup.
Latest Update:
This project is complete. This project experienced structure procurement/lead time delays, utility relocation delays, and weather delays. The contractor, Helix Group, completed the project on time and within the construction budget.
Timeline:
- 04/22/2021 - Invitation to Bid
- 05/19/2021 - Bid Opening
- 06/10/2021 - Board Approval
- 06/11/2021 - Notice of Award
- 06/22/2021 - Notice to Proceed
- 06/29/2021 - Pre-Construction Meeting

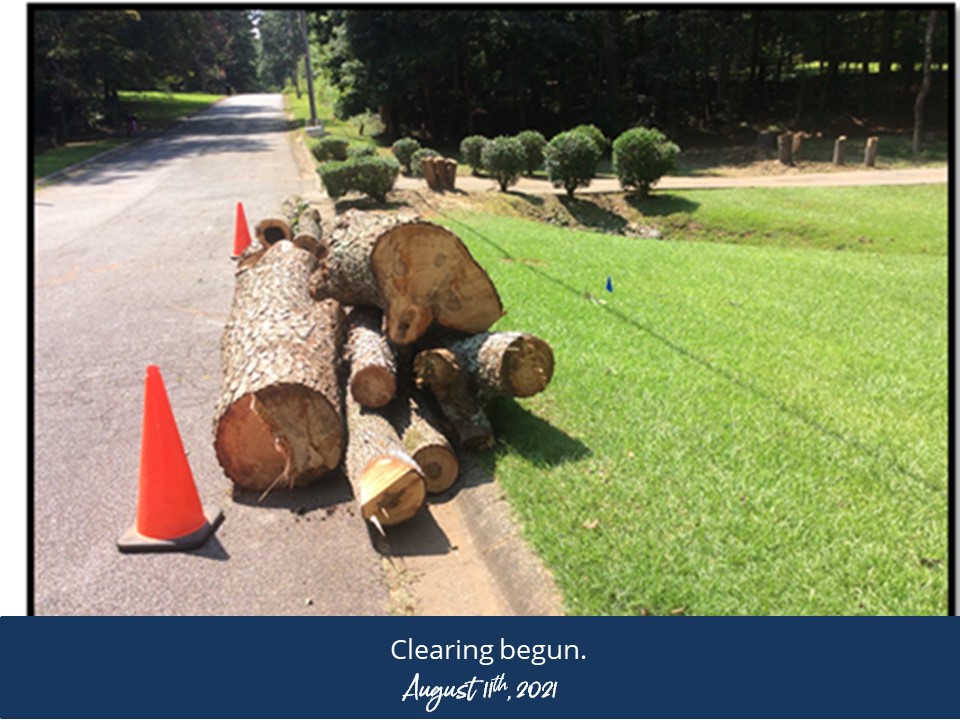

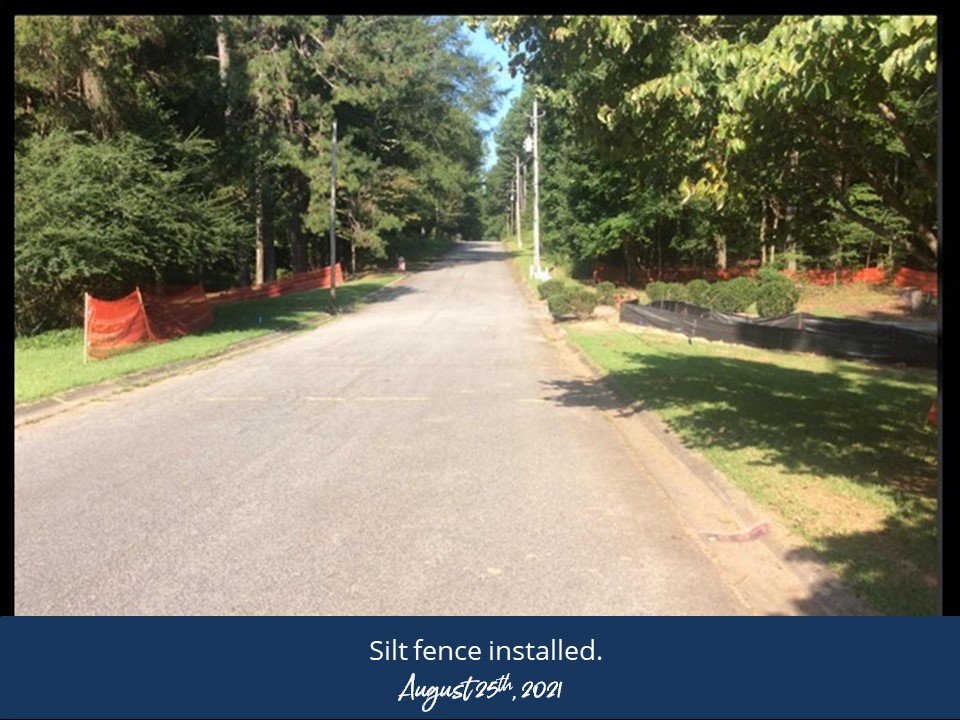

- 08/05/2021 - Clearing & Grubbing

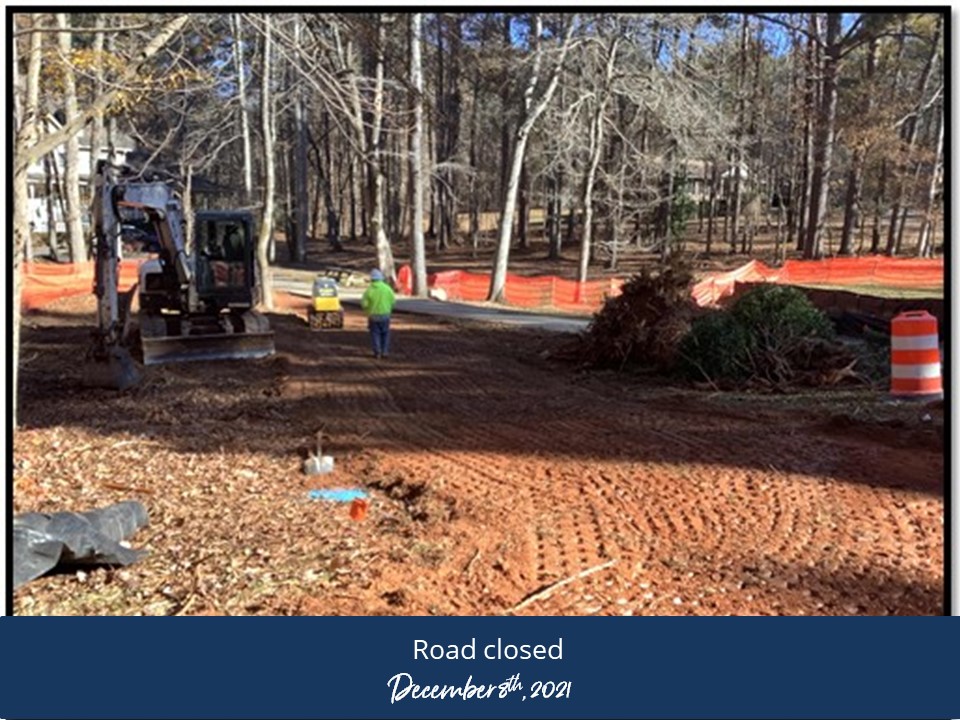

- 12/08/2021 - Road closed / Detour

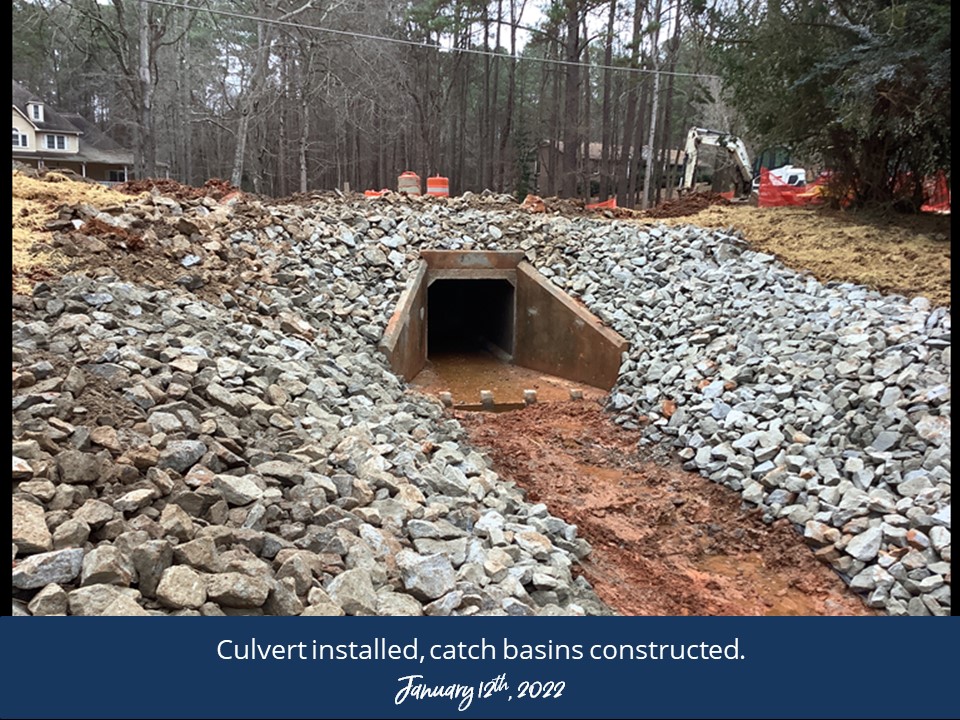

- 01/12/2022 - Culvert complete

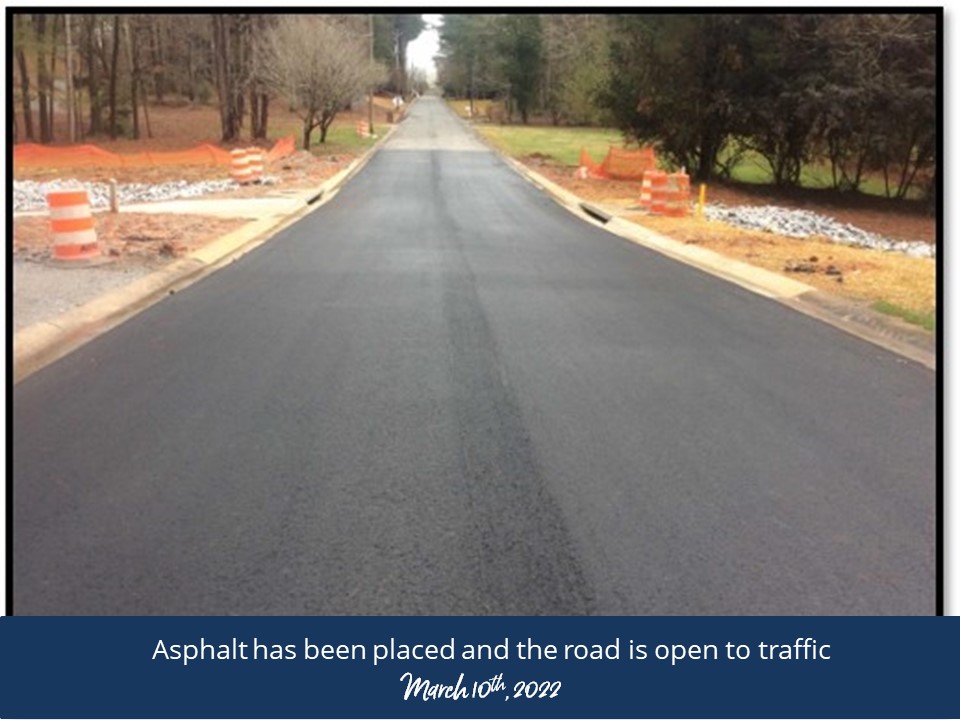

- 03/10/2022 - Road open / End of Detour
- 04/12/2022 - Substantial Completion
- 04/27/2022 - Final Completion
- Approved Budget: $362,207.00
- Category: Category II, Tier I
- Expended to Date: $400,772.00
- Designer: Tetra Tech
- Contractor: Helix Group, Inc.
