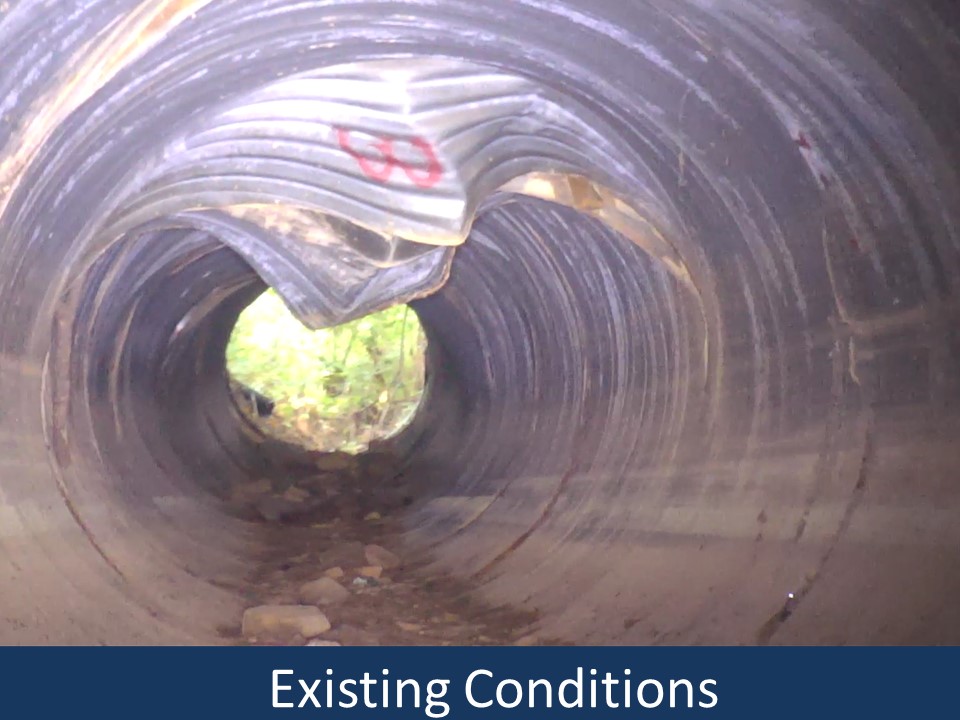

A 54-inch and a 24-inch corrugated metal pipe (CMP) under Heritage Way have been evaluated for replacement. They will be replaced with 54-inch and 24-inch reinforced concrete pipes (RCP).
Latest Update:
Project complete December 2023
- 09/28/2023: NTP Issued to Blount Construction Company, Inc
- 10/17/2023: Reinforced Concrete Pipe Delivered
- 11/07/2023: RCP installation complete
- 11/13/2023: Concrete work complete
- 11/14/2023: Asphalt paving complete
- 11/16/2023: Final Stabilization complete
- 11/20/2023: Substantial Completion
- 12/12/2023: Final Completion & Acceptance
- Approved Budget: $177,039.00
- Revised Budget: $189,911.00*
- Category: Category II, Tier II
- Expended to Date: $216,039.00
- Designer: Pond
- Contractor: Blount Construction Company, Inc.
